All-In-One Construction Accounting Software

  • Home
  • >
  • Product Update 26.0.3.34832 for Microsoft Dynamics 365 Business Central

Content

New Releases in this Updates

Update ID Type Title Functional Area
PE-476 New Feature

Introducing a New Project Class, "Contract" at the Highest Level

ProjectPro Basics

PE-670 New Feature

Reports for “Contract” Project Class – Actual vs Budget Work Units by Task, Pct of Completion, Variance Report, Combined AIA G702 and AIA G703

Reports

PE-679 New Feature

Add Rich Text Editor to the Project Quoting

Project Quoting

PE-681 New Feature

Performance Enhancement for Projects List and Project Card

ProjectPro Basics

PE-683 New Feature

Enhance the POC Report at the Master Level when associated with the "Contract Project Class" Project

Reports

PE-684 New Feature

Multi-Project Planning Lines Level Sorting in the Progress Billing Lines

Progress Billings

PE-700 Enhancement

Project Task No. Validation on Payment Journal

Payment Journal

PE-706 Enhancement

FA Purchase Order Posting with Project

ProjectPro Basics

PE-707 Enhancement

Due Date Calculation for Vendor Retention Ledger Entries

Account Payables

PE-709 Enhancement

Exclude CO Quotes from the Project Forecast Worksheet

ProjectPro Basics

PRJCTPR-513 Hot Fix

Duplicate Subcontract Ledger Entries

Subcontract

PRJCTPR-514 Improvement

Copy Project - "Completion Date" and "Revenue Recognized" get copied

ProjectPro Basics

PRJCTPR-515 Improvement

PFW by Task Total - Change to any non-End Total Type Task Line Adding to the PFW

Project Forecast

Note: Details are given below in “Release Note Details”.

Release Note Details

PE-476

New Feature – Introducing a New Project Class, “Contract” at the Highest Level

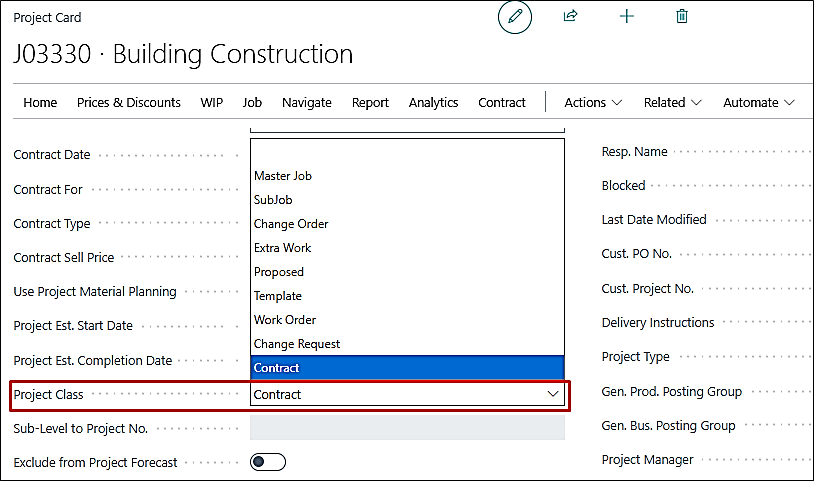

  • A new Project Class “Contract” has been added to the Project card. This is the highest level of the project, but will have no Budget lines, Billable lines (with exceptions), and no actual cost is incurred for it.

  • Release August  v1 image

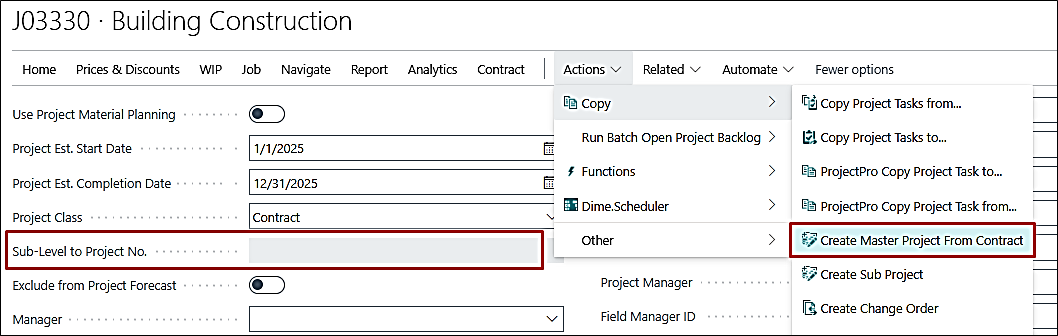

  • To create a Master project from the Contract project, a new action button has been created as “Create Master Project from Contract”.
  • Since this is the highest level, you are not allowed to assign a Contract job as a sub-level. Hence, the “Sub-Level to Project No.” on a Contract project will be non-editable.

  • Release August  v1 image

  • A new master project will be created for the Contract project.

  • Release August  v1 image

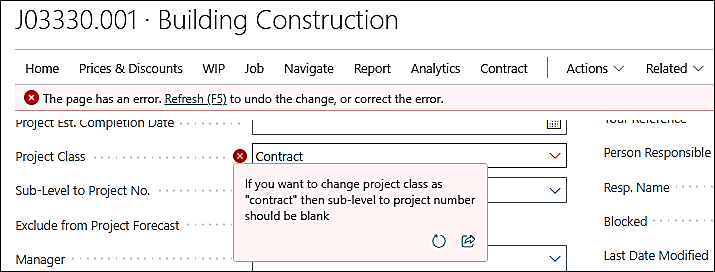

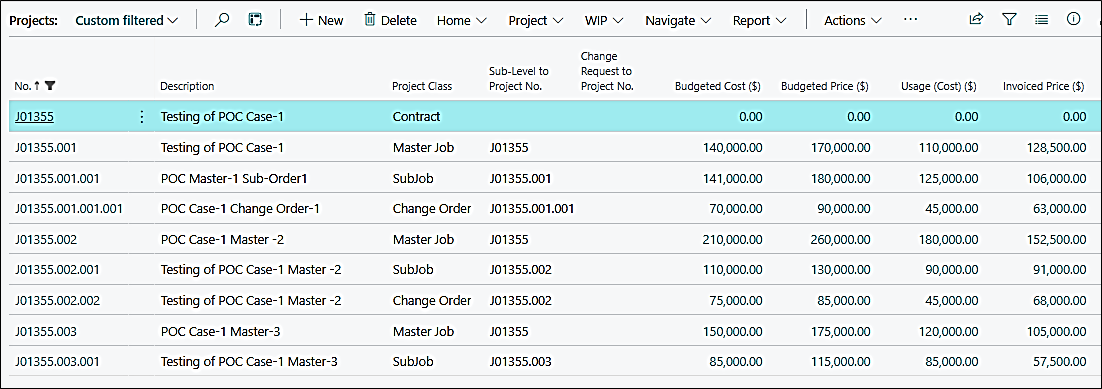

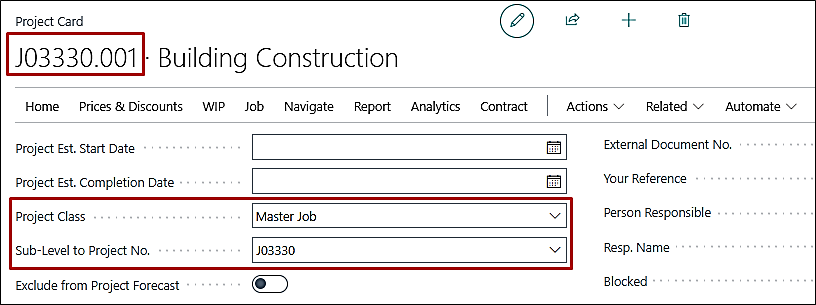

  • You are now allowed to change any project to a Contract project class if the “Sub-level to Project No.” value is defined.

  • Release August  v1 image

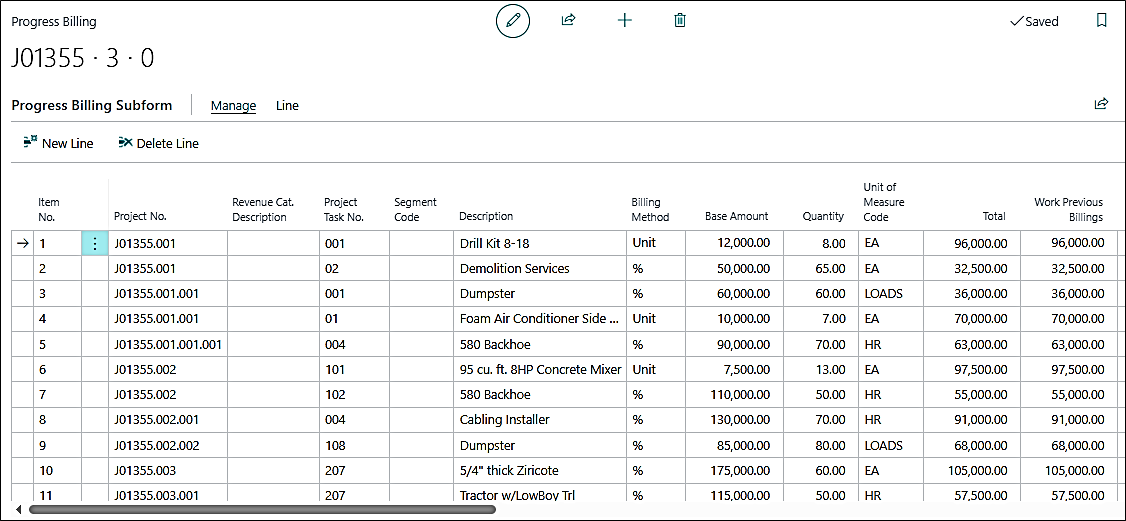

  • The contract project is used for collective billing of all the multi-tier sub-level projects together through Progress Billing.

  • Release August  v1 image

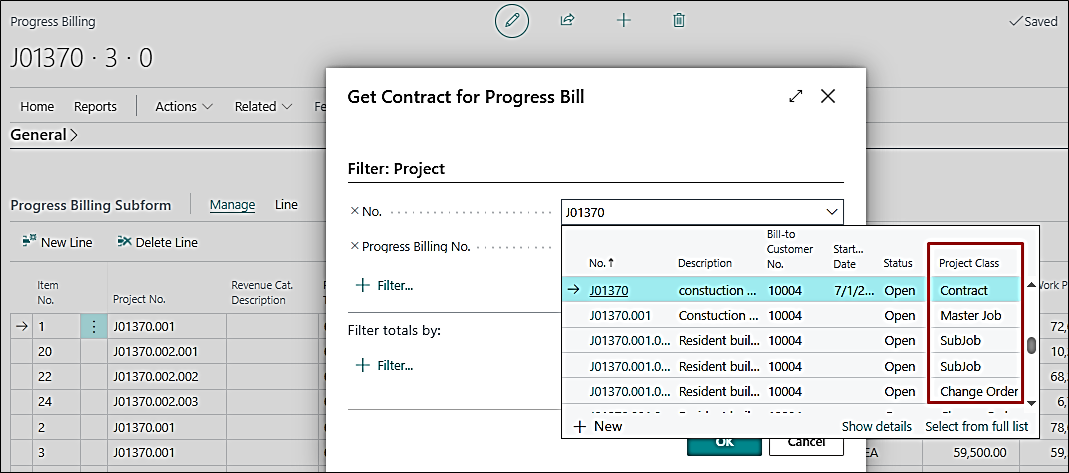

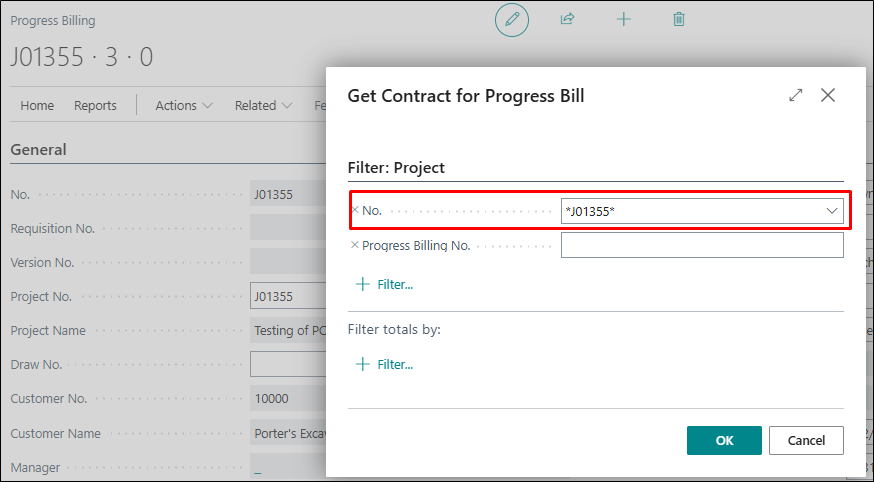

  • If the “Get Billings” function is used, then enter the contract Project No. in stars, e.g., *J01355*, to get all the Billables of all the related projects (master and their multi-tier sub-levels).

  • Release August  v1 image

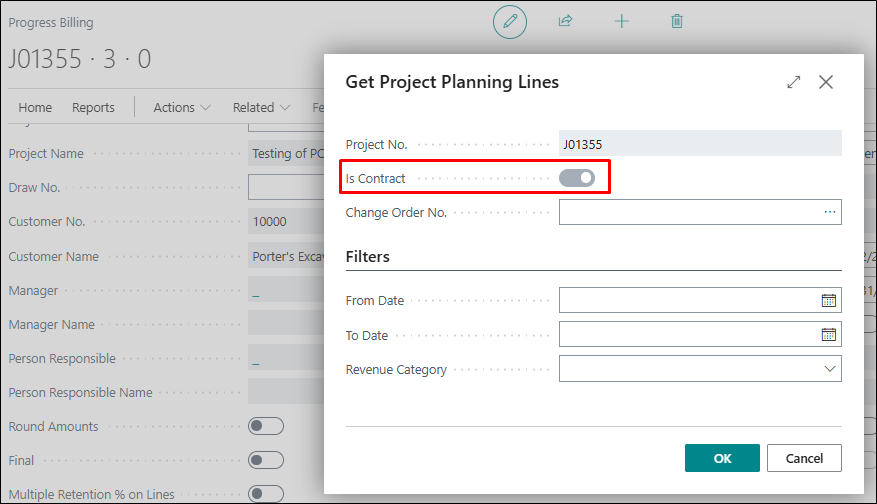

  • If the “Get Project Planning Lines” function is used, then a newly introduced “Is Contract” Boolean is set to True automatically, which shows all the Billable planning lines of all the related projects (master and their multi-tier sub-levels).

  • Release August  v1 image

  • The related Project No. will be displayed on the progress billing lines, and the invoiced amount will impact the related project itself. Hence, no impact or no budget/billable and actual/invoiced amount is attached to the Contract project, but you are eligible to perform billings of all the projects under one project.

  • Release August  v1 image

PE-670

New Feature – Reports for “Contract” Project Class – Actual vs Budget Work Units by Task, Pct of Completion, Variance Report, Combined AIA G702 and AIA G703

3 new reports have been introduced for the Contract Project (first 3 below), and 1 existing report has been enhanced to work with the Contract Project:

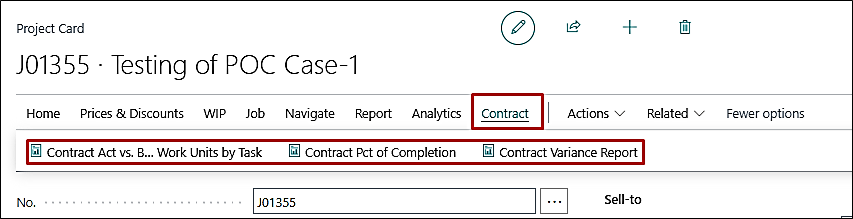

  • Contract Actual vs Budget Work Units by Task
  • Contract Pct of Completion
  • Contract Variance Report

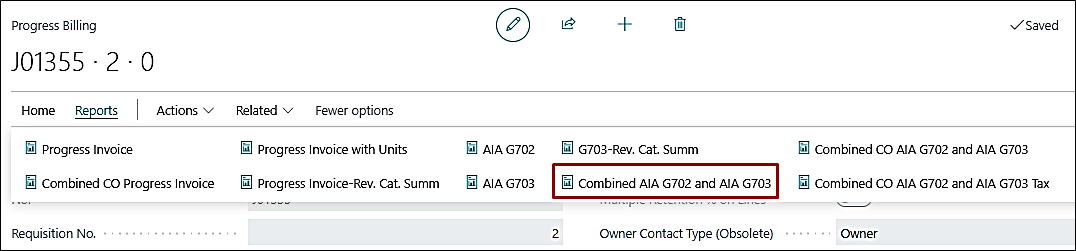

  • Combined AIA G702 & AIA G703

  • Release August  v1 image

    Release August  v1 image

PE-679

New Feature – Add Rich Text Editor to the Project Quoting

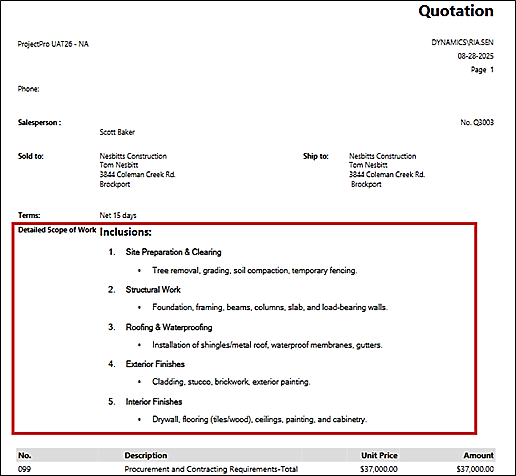

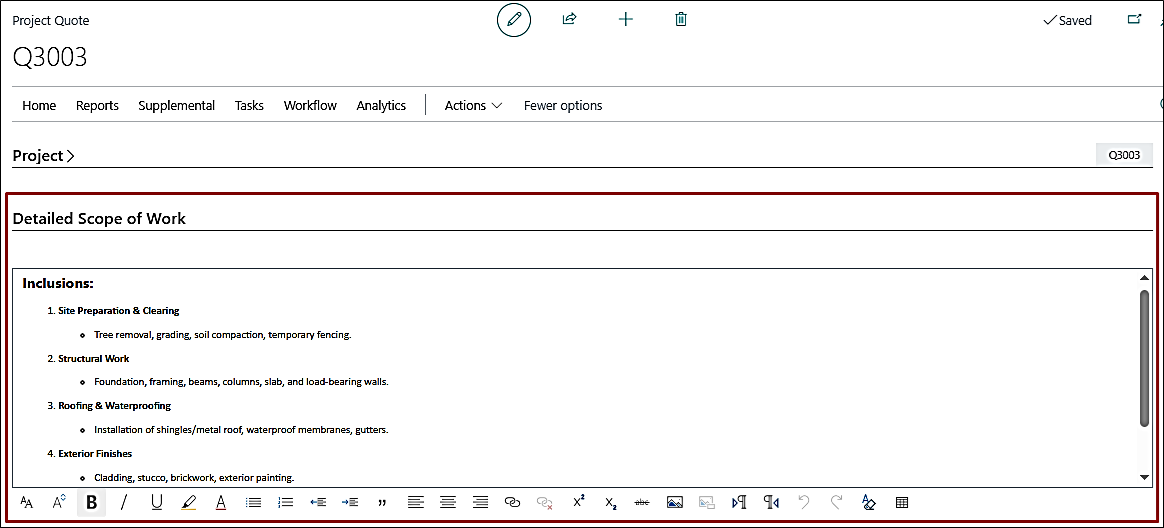

A new fast tab has been added to the Project Quote titled “Detailed Scope of Work”. This is a Rich Text Editor field.

Release August  v1 image

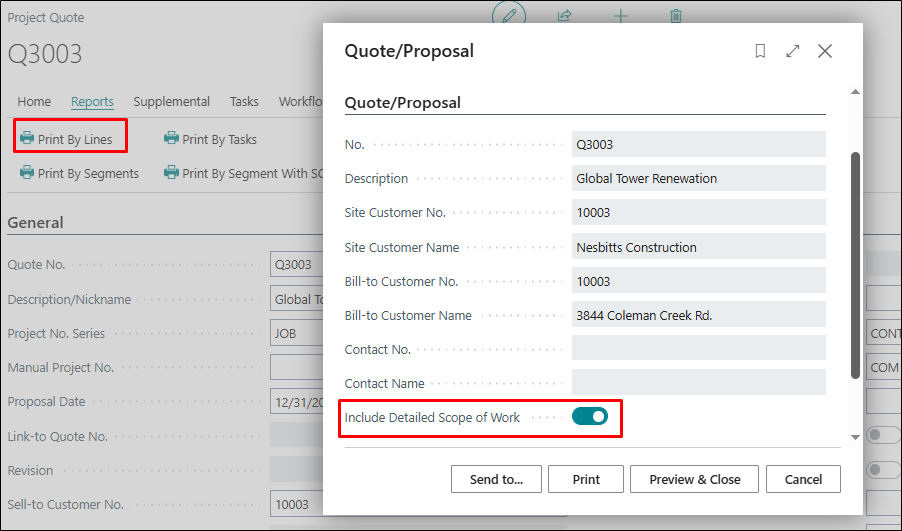

This can also be printed on the “Print by Lines” report if you enable “Include Detailed Scope of Work” on the report request page.

Release August  v1 image

Release August  v1 image

PE-681

New Feature – Performance Enhancement for Projects List and Project Card

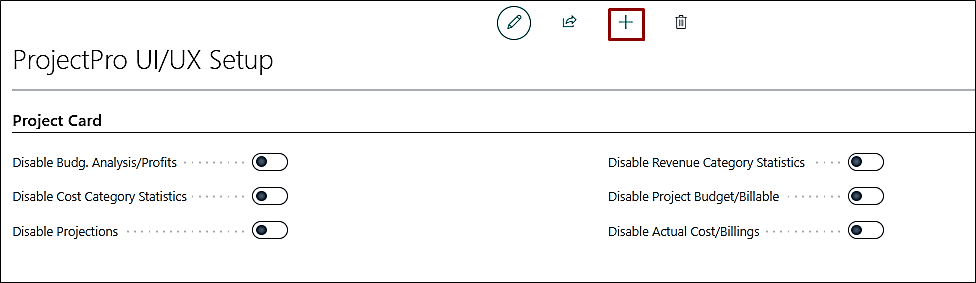

A new page, “ProjectPro UI/UX Setup”, has been created. This controls the fast tabs of the project card. Enabling the setup will disable the corresponding fast tabs on the project card.

Note: Click on “New (+ Sign)” when setting up this page for the first time for an entity.

Release August  v1 image

PE-683

New Feature – Enhance the POC Report at the Master Level when associated with the "Contract Project Class" Project

The “Pct of Completion” report is enhanced to run on the Master Project when it is assigned as a sub-level to the Contract project.

PE-684

New Feature – Multi-Project Planning Lines Level Sorting in the Progress Billing Lines

A new feature has been added to sort the Project Planning Lines for Progress Billings.

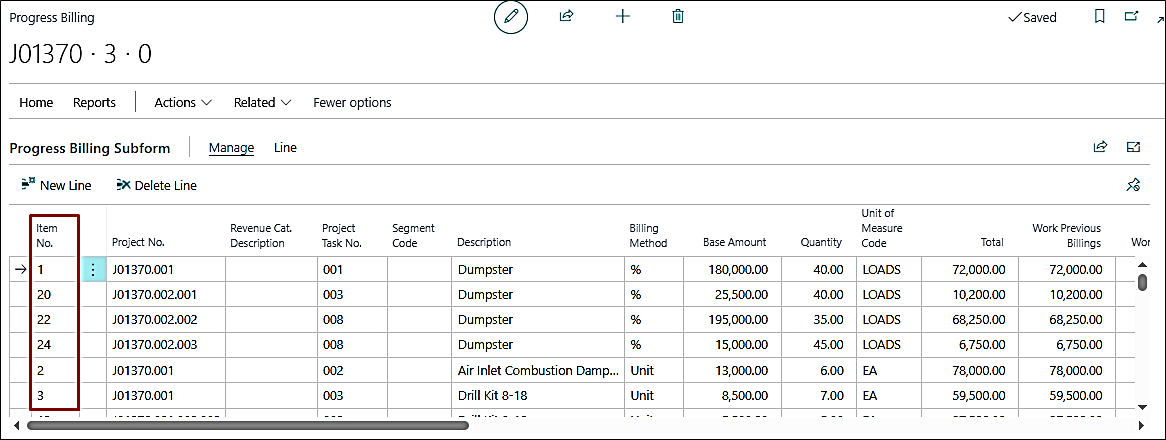

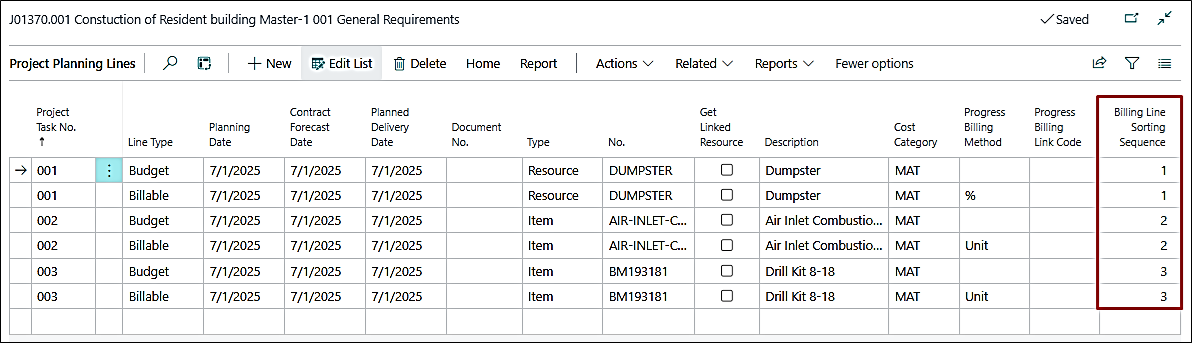

  • Project Planning Lines – Billing Line Sorting Sequence
    • You can now set the sorting sequence on the billing planning lines using the “Billing Line Sorting Sequence” to be used on the Progress Billings, such as clubbing the Types (item, resource, g/l) together, clubbing the Task No., or by other relevant fields.
    • o The sorting sequence can be assigned across different levels of the projects to see a particular type of line together on the progress billing.
    • This allows users to quickly locate specific categorizations or entries, which improves visibility and efficiency.

  • Release August  v1 image

  • Integration with Progress Billing and its Reports
    • Sorting applied in the Project Planning Lines will reflect in the Progress Billing lines.
    • You can modify the sequence directly in the Progress Billing lines as well. This does not back update the planning lines with the modified sequence here.

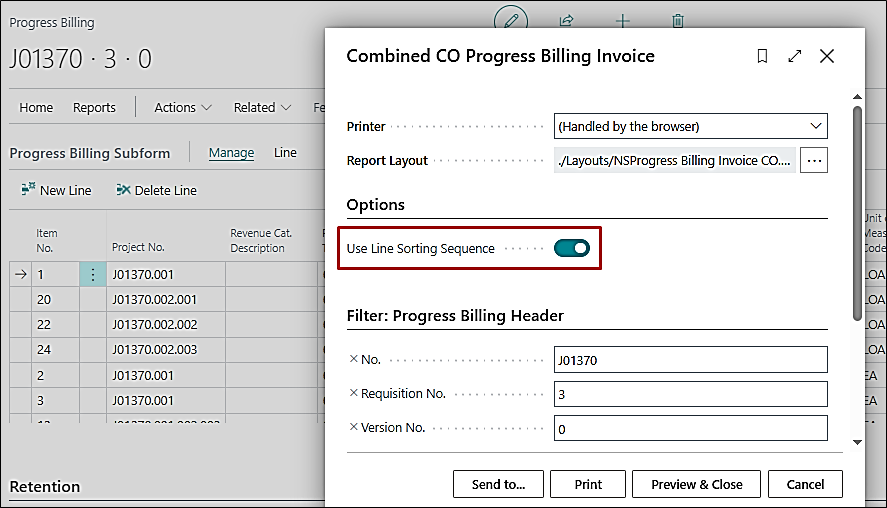

    • The Progress Billing reports will display data according to the applied sorting using the setting “Use Line Sorting Sequence” added to the report request pages, ensuring consistency between the user view and generated reports.

  • Release August  v1 image

    Release August  v1 image

    Release August  v1 image

  • Additional Enhancements to “Get Billings” Function
    • User-specific sorting is applied at the “Get Billings” line, i.e., the lines will be added to the progress billing lines based on the sorting sequence set on the project planning lines.
    • The “Project Class” is displayed in the dropdown for better context.

  • Release August  v1 image

    Expected Outcome:

    • Faster navigation and improved accuracy in both planning and billing modules.
    • Consistent reporting and enhanced user experience.

PE-700

Enhancement – Project Task No. Validation on Payment Journal

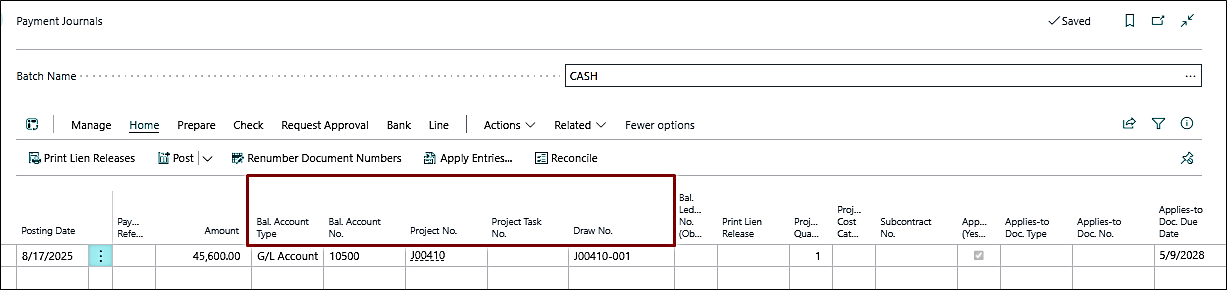

On the Payment Journal, when “Project No.” and “Draw No.” are defined but “Project Task No.” is blank, the system should skip creating a Project Ledger Entry as previously and still allow posting.

  • The system should bypass Project Ledger Entry creation and allow successful posting of the transaction when the following conditions are met:
    • The “Bal. Account Type” field is "G/L Account"
    • The “Bal. Account Type” field is "G/L Account"
    • The "Project No." field is not blank
    • The "Project Task No." field is blank
    • The "Draw No." field is not blank
  • This ensures posting can proceed without error.

  • Release August  v1 image

    Release August  v1 image

Reason for Changing the Logic:

When a Payment Journal entry is created with “Bal. Account Type = G/L Account” and uses "Applies-to Doc. No.", the system auto-fills the “Project No.” but leaves the “Project Task No.” blank. Since both fields are non-editable, the system requires a Project Task No. if Project No. is present. This causes a posting error and blocks the transaction.

PE-706

Enhancement – FA Purchase Order Posting with Project

On the purchase lines, if the Type is “Fixed Asset”, the user will not be allowed to add a “Project No.” and vice versa on the Purchase Order, Purchase Invoice, Purchase Quotes, and Purchase Credit Memo.

The user should select the “FA Job No.” on the purchase lines for Type = Fixed Assets.

PE-707

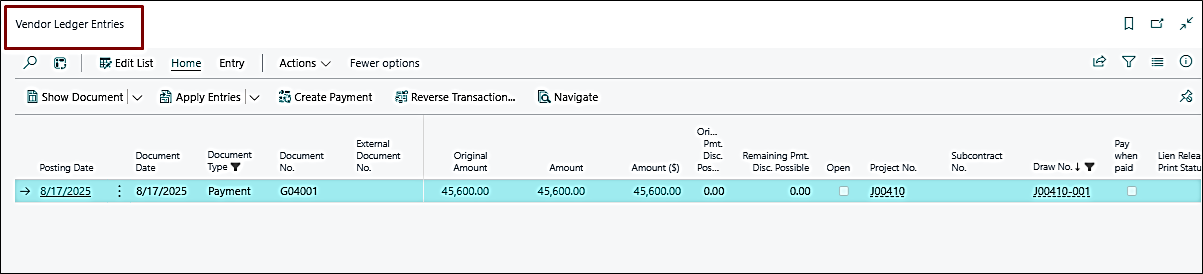

Enhancement – Due Date Calculation for Vendor Retention Ledger Entries

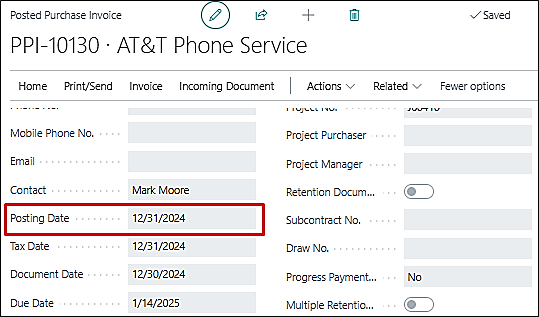

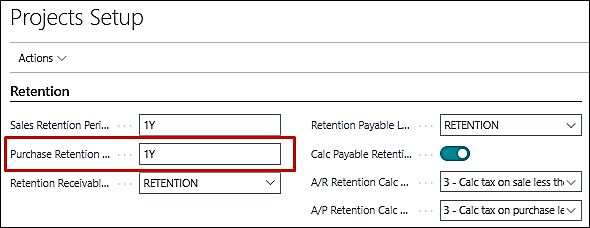

For vendor ledger entries where the Retention Ledger Code is set to "Retention", the “Due Date” calculation logic has been changed to: Due Date = Posting Date + Purchase Retention Period

Release August  v1 image

Release August  v1 image

Release August  v1 image

Reason for Changing the Calculation Logic:

  • If a document was created on a specific date (Document Date), but
  • Was posted partially across multiple posting dates.
  • Under the previous logic, all partial postings derived the same due date from the original “Document Date”, which was not aligned with actual posting timelines.
  • Note: This impact only applies to new vendor ledger entries.

    PE-709

    Enhancement – Exclude CO Quotes from the Project Forecast Worksheet

    Change Order Quotes have been excluded from the Project Forecast Worksheet. It will now only be included after it is converted into a Change Order.

    PRJCTPR-513

    Hot Fix – Duplicate Subcontract Ledger Entries

    While posting the purchase invoice from the sub-contract, duplicate Subcontract Ledger Entries were being created. As a result, the cost was also doubled in the “Cost Category” tab of the Subcontract.

    PRJCTPR-514

    Improvement – Copy Project Function – “Completion Date” and “Revenue Recognized”

    The "Completion Date" and "Revenue Recognized" fields no longer get copied while copying a Project.

    PRJCTPR-515

    Improvement – PFW by Task Total – Change to any non-End Total Type Task Line Adding to the PFW

    When a project is set with “Forecast Method = Job Forecast by Task Totals”, and if any change is made to a task line with its Type not being set to “End Total”, then that task is added to the project forecast. This has been fixed now.
